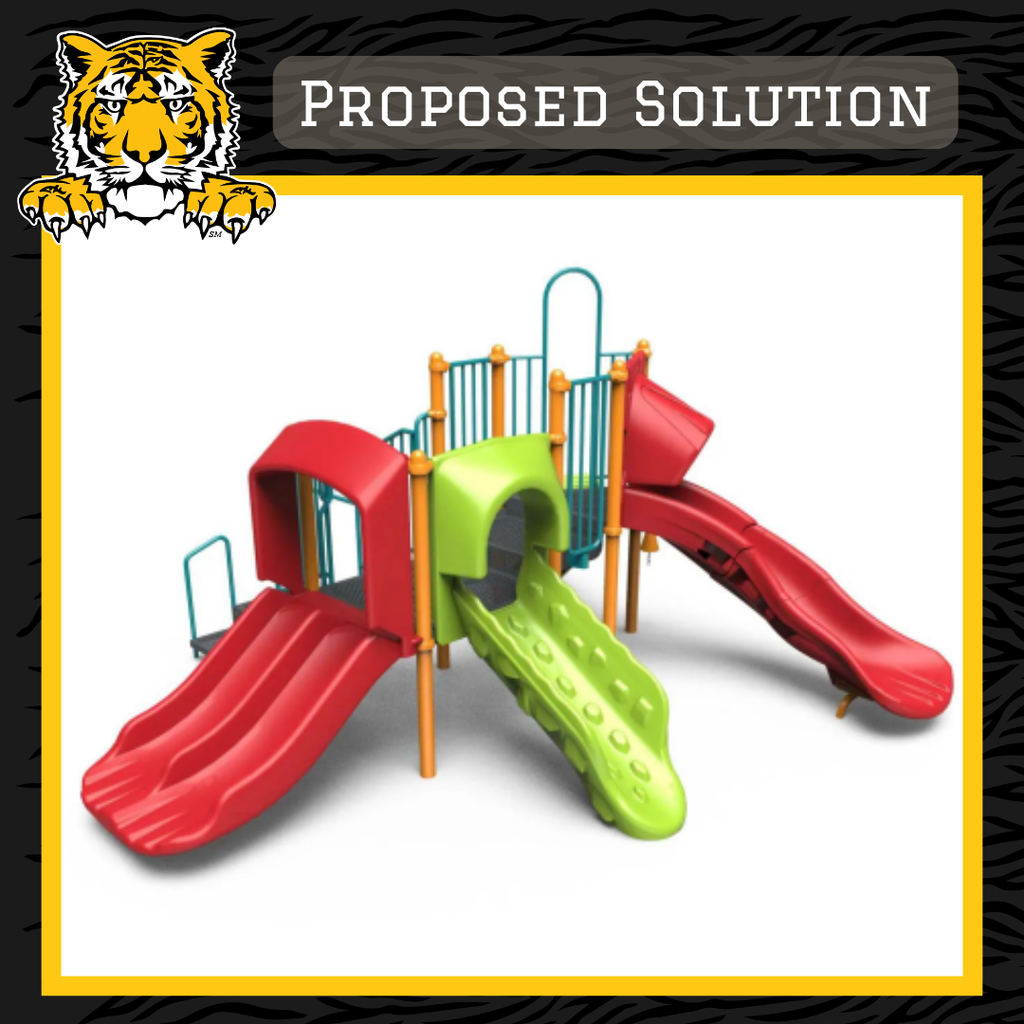

Smithton Board of Education votes 7-0 to approve Long Range Facility Plan and Proposition T.I.G.E.R. Together Investing in Growth, Environments and Resources
A huge thank you to the Long Range Facility Planning Team for their dedication over the last several months. The team of community members, staff and board members met to evaluate the campus from top to bottom. They then created categories and project lists for campus improvements. The entire plan they developed can be found on our website following this link.

The top priority projects were designated as “Priority 1” and determined to need immediate attention. These were primarily Exterior Projects and help to alleviate some of the safety concerns noted during the evaluation:

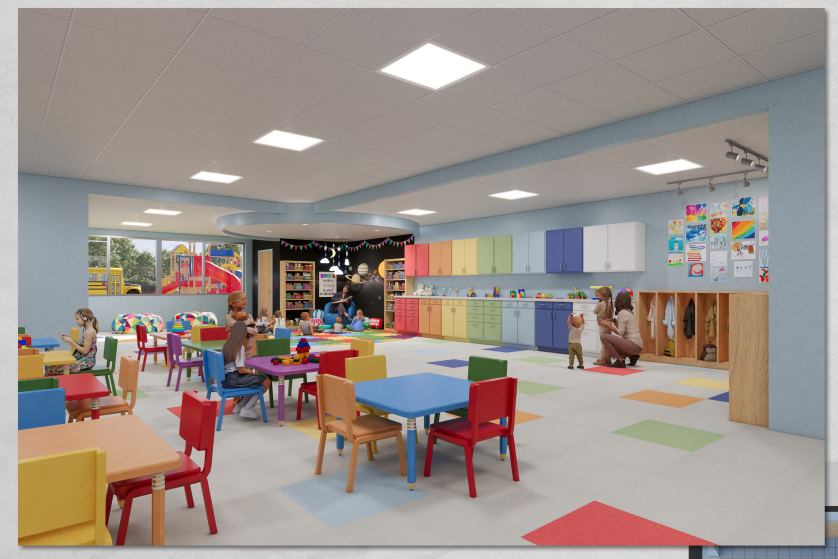

In order to fund these projects the board voted unanimously to place an election on the April 7, 2026 ballot. Voters in the district will have the opportunity to approve a $0.45 increase to the total levy for the school district.

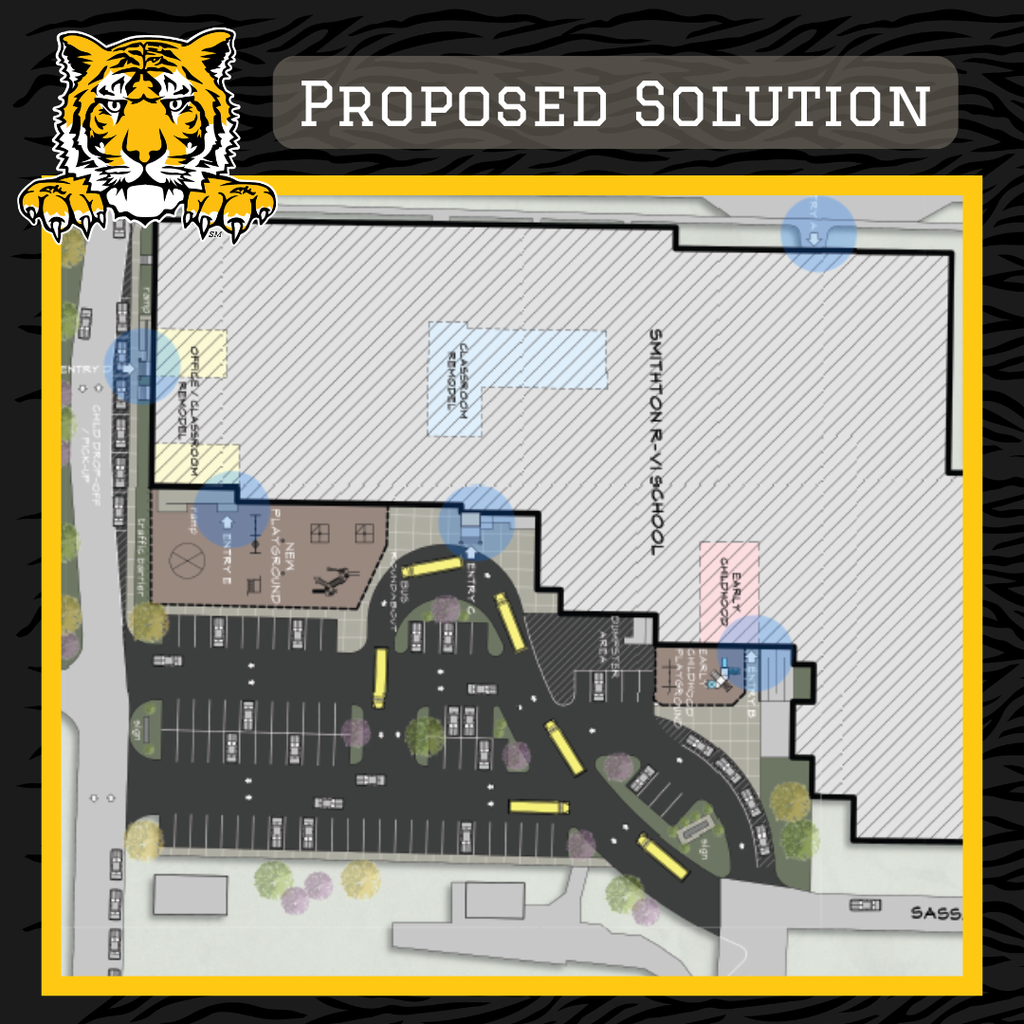

The plan would include modifications to Coombs St. as opposed to previous plans that included taking over the street.
Please share this information with others and plan to vote on April 7, 2026.

https://app.smore.com/n/tx26v
We keep track of our student performance on state testing (often called MAP Testing) as compared to our Kaysinger Conference schools. Over the past few years we have been ranked #4 and #6 and #7 out of our 9 tested conference schools. Our goal is to be in the top third and our Comprehensive School Improvement Plan (CSIP) focuses on academic achievement and recruitment and retention of quality staff. The bond proceeds will allow us to not take away from our operating levy (Fund1), which allows us to pay our staff and remain competitive in the region for pay. Not taking from that levy means that we can
better meet our salary and wage goals, which are part of our recruitment and retention priority in our CSIP.

Once a bond issue passes, the full amount of the funds become available within 30 days. The funds will be held in a separate bank account at any bank of the district’s choosing that can properly collateralize the funds.

Colby Bryan- 5th place Probability and Statistics
Sienna Contreras- 4th place Analytic Geometry 12
Aaden Foster- 5th place Word Problems 11
Codee Niebruegge- 1st place Word Problems 10, Geometry 10, 5th place Hodgepodge 10
Maddie Cole- 3rd place Word Problems 10
Dei Moore- 5th place Word Problems 9, 4th place Geometry 9
4th place Team 10- Codee Niebruegge, Maddie Cole, Zoie Shapely
5th place Team 11- Aaden Foster, Landon Eastep
4th place Team 12- Colby Bryan, Austin David
5th place Mixed Team- Sienna Contreras, Lizzy Lauer
3rd Top Sophomore- Codee Niebruegge

Don’t miss out — enroll now before classes fill up!
Our program is open to students starting Kindergarten this fall through incoming 8th graders.

Weekly update:
Elementary update
When did the Long Range Facility Plan start?
The Long Range Facility Plan team was formed from a group of interested community members, staff members and board members in the summer of 2025 with the first meeting on September 4, 2025. Members reviewed facility condition audit information collected by other members in the following categories: site work, building envelope and building interior. The group then reviewed audit information gathered from industry technicians in the following categories: plumbing systems, electrical systems, technology systems and a complete Safety Assessment. All of this information was organized into four Project Sections: Exterior Projects, Interior Projects, Campus Resource Projects and Competition and Performance Space Projects. From this information a plan developed which included priorities of 1 through 5. This plan was adopted by the Smithton R-VI Board of Education during the regular public meeting held on January 26, 2026.

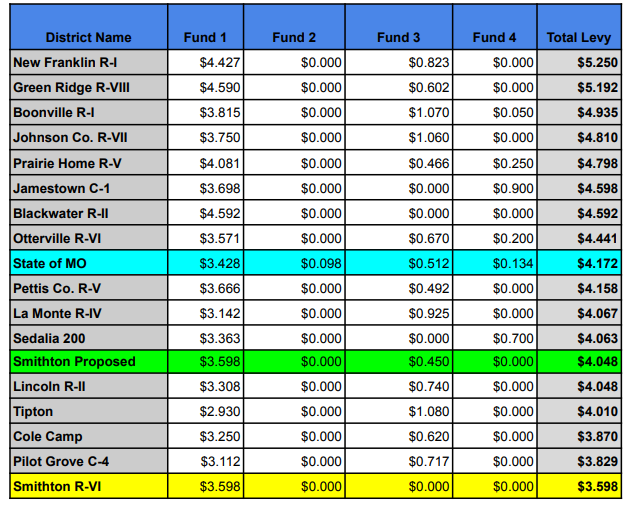

Our current tax levy (the sum of each fund) is less than the state average and low compared to schools in our region with similar economics. With a modest debt service levy (Fund 3) of $0.45 our total proposed levy would remain less than state average but competitive with schools in our region.

Why is the plan that claimed Coombs St. not happening?

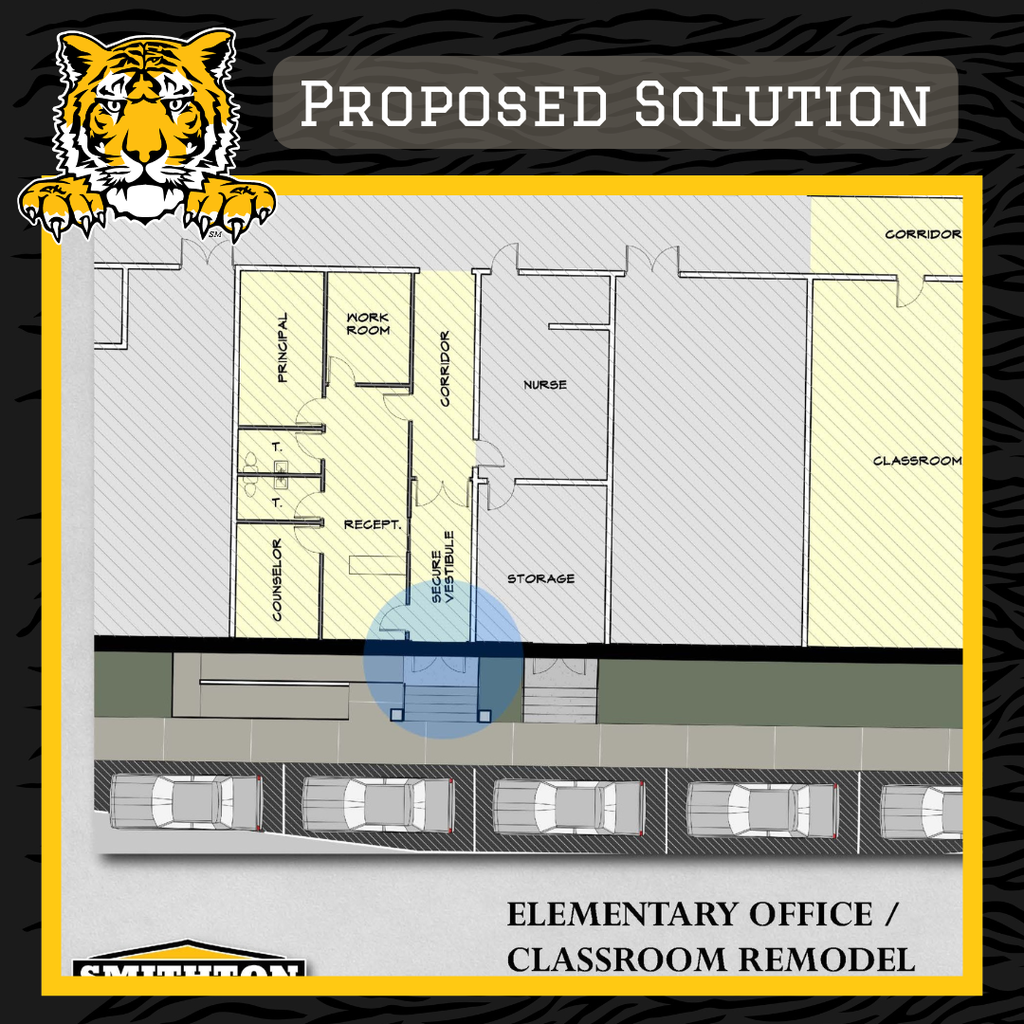

The Long Range Facility Team felt it was important to look at other options to meet the recommended changes. The safety and security issues identified previously with the current elementary school entrance and playground still exist, however the plan to permanently take over the section of Coombs St. directly south of the elementary school was not viewed as ideal for the community. Therefore, a new plan was created that would modify Coombs St. and incorporate a third lane for school use only and renovate space to create a new elementary school entrance and new offices and classrooms. This change was approved by the Smithton R-VI Board of Education through the adoption of the Long Range Facility Plan. The school district and the City of Smithton have established an agreement approved by the City Council that allows for Coombs to be modified by the school district to the south of the elementary school between Marvin and Myrtle Ave. without shutting it down.
